Examining the Effect of Project Risk Management on Demolition Performance in Construction Projects: A Case Study of the Dilapidated Buildings of Najaf City, Iraq

Document Type : Case Study

Authors
1 Ph.D. Candidate, Civil Engineering, Construction Management, Aras International Campus, University of Tehran, Tehran, Iran
2 Assistant Professor, Construction Engineering and Management Division, School of Civil Engineering, College of Engineering, University of Tehran, Tehran, Iran
Abstract
Demolition is the first and inherently most hazardous stage of the urban-regeneration cycle, yet within the construction risk-management literature it has received a disproportionately small share of attention. In historic and religious urban fabrics such as Najaf city in Iraq, the demolition process is compounded by high building density. The present study aims to determine the extent to which project risk management affects demolition performance in construction projects, focusing on the dilapidated buildings of the city of Najaf. The research is applied in purpose and descriptive–survey in method. The statistical population comprised 175 project managers, supervising engineers, site superintendents, and safety experts involved in demolition projects in Najaf. Data were gathered with a researcher-made questionnaire on a five-point Likert scale whose content validity and reliability were confirmed. Data were analysed in SPSS using the Kolmogorov–Smirnov test, Pearson correlation, and simple linear regression. Project risk management was a significant predictor of demolition performance. The adjusted coefficient of determination was 0.717, indicating that 71.7% of the variance in demolition performance is explained by project risk management; the standardized regression coefficient of 0.847 denotes a strong, positive linear relationship, confirmed at a significance level of 0.0001 with a Durbin–Watson statistic of 2.264. Investment in project risk management yields a significant improvement in the safety, schedule, cost, and quality of demolition. For historic religious fabrics such as Najaf, a systematic, context-sensitive risk-management framework based on the five-stage PMBOK process should be institutionalized as a legal prerequisite for issuing demolition permits.

Graphical Abstract

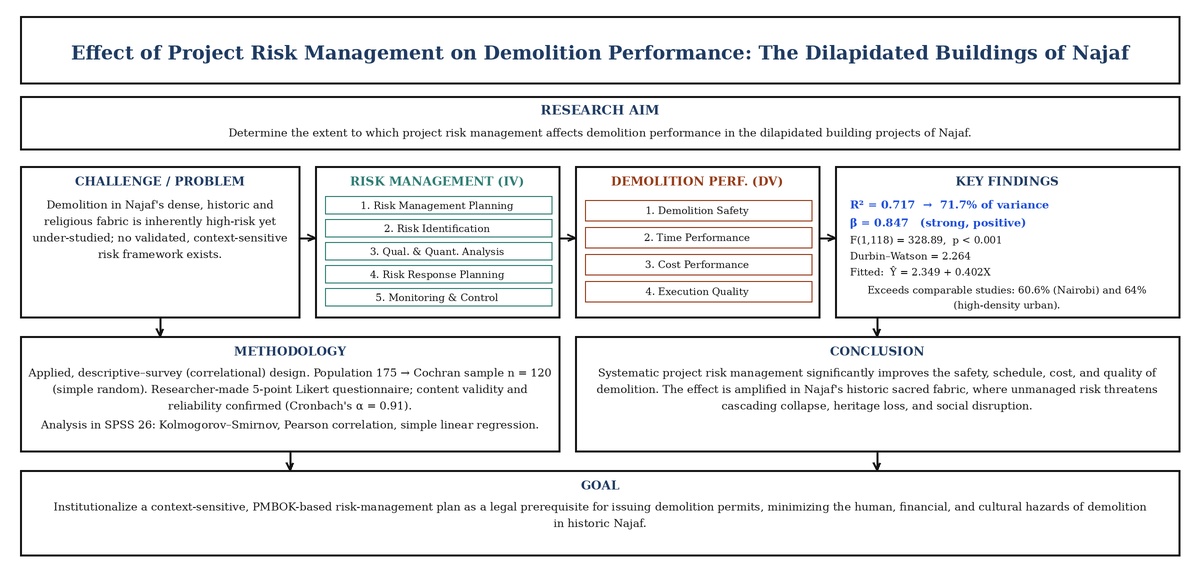

Examining the Effect of Project Risk Management on Demolition Performance in Construction Projects: A Case Study of the Dilapidated Buildings of Najaf City, Iraq

Highlights

●        Project risk management is a strong, significant predictor of demolition performance, explaining 71.7% of its variance (β = 0.847, p < 0.001) in the dilapidated buildings of Najaf.

●        The five-stage PMBOK risk process-planning, identification, quantitative and qualitative analysis, response, and monitoring and control jointly improves the safety, schedule, cost, and execution quality of demolition.

●        In historic and religious fabrics such as Najaf, structural and socio-cultural risks carry the highest weight and require a context-sensitive rather than a generic risk-management framework.

●        The explanatory power obtained here (R² = 0.717) exceeds comparable studies (60.6% in Nairobi; 64% in high-density urban areas), reflecting the heightened stakes of demolition near the sacred shrine.

●        Embedding an approved, context-sensitive, PMBOK-based risk-management plan as a legal prerequisite for issuing demolition permits is recommended to minimize the human, financial, and cultural hazards of demolition.

Keywords

·        Abotaleb, I. S., El-Adaway, I. H., & Ali, A. (2023). A framework for risk assessment of demolition projects in historic urban fabrics. Journal of Building Engineering, 68, 106–119.
·        Adi, T. J. W., Devia, Y. P., & Andriyani, N. (2025). Integrating building information modeling and Bayesian network for enhanced go/no-go decisions in building demolition projects. Global Journal of Environmental Science and Management, 11(3), 1259. https://doi.org/10.22034/gjesm.2025.03.21
·        Amaechi, C. V., Reda, A., Beddu, S. B., Mohamed, D. B., Syamsir, A., Ja'e, I. A., Ullah, S., Deng, X., Huang, B., Wang, C., & Ju, X. (2025). A systematic literature review on knowledge management for project risk management in construction. Journal of Building Engineering. https://doi.org/10.1016/j.jobe.2025.114216
·        Ayyildiz, E., Karaca, T. K., Kara, B., Kavus, B. Y., & Aydin, N. (2025). Picture-fuzzy decision-making tool for enhanced risk prioritization in construction and demolition waste management: A hybrid FMEA–Fine–Kinney–SWARA–TOPSIS approach. Buildings, 15(22), 4143. https://doi.org/10.3390/buildings15224143
·        Buniya, M. K., Othman, I., Sunindijo, R. Y., Kashwani, G., Durdyev, S., Ismail, S., Antwi-Afari, M. F., & Li, H. (2021). Critical success factors of safety program implementation in construction projects in Iraq. International Journal of Environmental Research and Public Health, 18(16), 8469. https://doi.org/10.3390/ijerph18168469
·        Canbal Vedi, A., & Sözen, A. Z. (2026). Risk management maturity, contract provisions and project success: An integrated assessment for the Turkish construction sector. Black Sea Journal of Engineering and Science, 9(1), 385–390. https://doi.org/10.34248/bsengineering.1743327
·        Chen, H., & Liu, S. (2024). Risk management practices and demolition project success: An empirical study in high-density urban areas. Journal of Construction Engineering and Management, 150(5), 04024023.
·        Ding, R., & Liu, Z. (2024). An IT2FS-ANP- and IT2FS-CM-based approach for conducting safety risk assessments of nuclear power plant building projects. Mathematics, 12(7), 1038. https://doi.org/10.3390/math12071038
·        García-Prada, J. C., López-Arquillos, A., & Rubio-Romero, J. C. (2023). Risk assessment in demolition works: A comparative analysis of European regulations and practices. Safety Science, 158, 105–117.
·        Islam, N., Sandanayake, M., Muthukumaran, S., & Navaratna, D. (2024). Review on sustainable construction and demolition waste management—Challenges and research prospects. Sustainability, 16(8), 3289. https://doi.org/10.3390/su16083289
·        Karugu, W. H., Mburugu, K. N., & Njeru, D. M. (2026). Risk and contract management practices, and construction projects performance: A test of moderation by managerial skills. PLoS ONE, 21(7), e0352974. https://doi.org/10.1371/journal.pone.0352974
·        Kim, J. Y., Park, K. H., & Chung, K. R. (2025). Proposal of a practical risk assessment procedure for structural safety management in building demolition. Journal of the Korea Institute of Building Construction, 25(6).
·        Krejcie, R. V., & Morgan, D. W. (1970). Determining sample size for research activities. Educational and Psychological Measurement, 30(3), 607–610. https://doi.org/10.1177/001316447003000308
·        Lin, C.-L., & Chen, B.-K. (2021). Research for risk management of construction projects in Taiwan. Sustainability, 13(4), 2034. https://doi.org/10.3390/su13042034
·        Nadazdi, A., Naunovic, Z., & Ivanisevic, N. (2022). Circular economy in construction and demolition waste management in the Western Balkans: A sustainability assessment framework. Sustainability, 14(2), 871. https://doi.org/10.3390/su14020871
·        Nakamura, K., Tanaka, H., & Sato, M. (2024). Safety risk management in demolition of aging buildings: A case study of Japanese urban redevelopment. Safety Science, 172, 106–121.
·        Patel, D. J., & Patel, D. A. (2025). Development of demolition project hazard index using the possibility approach. International Journal of Construction Management, 25(3), 301–315. https://doi.org/10.1080/15623599.2024.2317220
·        Project Management Institute. (2021). A guide to the project management body of knowledge (PMBOK guide) (7th ed.). Project Management Institute.
·        Schützenhofer, S., Kovacic, I., Rechberger, H., & Mack, S. (2022). Improvement of environmental sustainability and circular economy through construction waste management for material reuse. Sustainability, 14(17), 11087. https://doi.org/10.3390/su141711087
·        Silva, R. V., & Santos, J. M. (2024). Environmental and social risk management in demolition projects: A systematic review and framework proposal. Sustainable Cities and Society, 101, 105–118.
·        Soltanzadeh, A., Mahdinia, M., Omidi Oskouei, A., Jafarinia, E., Zarei, E., & Sadeghi-Yarandi, M. (2022). Analyzing health, safety, and environmental risks of construction projects using the fuzzy analytic hierarchy process. Sustainability, 14(24), 16555. https://doi.org/10.3390/su142416555
·        Soyinka, O. A., Wadu Mesthrige, J., Hewage, U. W. A. L., & Oladinrin, T. O. (2023). Scientometric review of construction demolition waste management: A global sustainability perspective. Environment, Development and Sustainability, 25(10), 10533–10565. https://doi.org/10.1007/s10668-022-02537-7
·        Su, G., & Khallaf, R. (2022). Research on the influence of risk on construction project performance: A systematic review. Sustainability, 14(11), 6412. https://doi.org/10.3390/su14116412
·        Tavakol, M., & Dennick, R. (2011). Making sense of Cronbach's alpha. International Journal of Medical Education, 2, 53–55. https://doi.org/10.5116/ijme.4dfb.8dfd
·        Teng, L., & Latif, H. A. (2026). Risk and safety management in construction: Examining the interplay of organizational commitment and project complexity. International Review of Management and Marketing, 16(4), 603–611. https://doi.org/10.32479/irmm.23577
·        Turkyilmaz, A. H., & Polat, G. (2025). Identification and classification of risks in construction projects: Clusters, trend studies and risk breakdown structure. Engineering, Construction and Architectural Management. https://doi.org/10.1108/ECAM-01-2025-0161
·        Yu, Y., Zhang, J., & Wang, L. (2024). Integrated risk management and project performance in complex urban renewal projects: The mediating role of organizational resilience. International Journal of Project Management, 42(3), 102–118.
·        Zhao, J., Du, X., Guo, H., & Li, L. (2024). Risk management and its relationship with innovative construction technologies with a focus on building safety. International Journal of System Assurance Engineering and Management, 15(8), 4050–4068. https://doi.org/10.1007/s13198-024-02410-y
·        Zhasmukhambetova, A., Evdorides, H., & Davies, R. J. (2025). Integrating risk assessment and scheduling in highway construction: A systematic review of techniques, challenges, and hybrid methodologies. Future Transportation, 5(3), 85. https://doi.org/10.3390/futuretransp5030085
Volume 7, Issue 1 - Serial Number 1
Winter 2026
Pages 331-344

  • Receive Date 11 May 2026
  • Revise Date 10 September 2026
  • Accept Date 30 September 2026
